Estimating 8-10 Months to First Megapack Made in Texas

Information from someone who lives and works in the area, online transcripts from the public meetings and public reports, Grok 3 analysis (based upon my giving it my view of the context to get to first megapack production at the new megapack factory in Texas gives this 6 month timeline.

– 8-10 month timeline likely

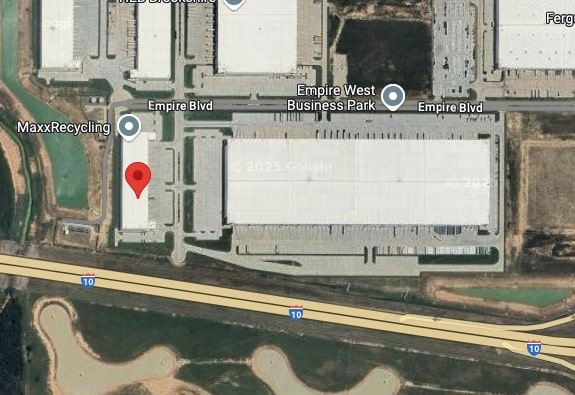

– 1.77 million sf of building. 1.03 million building getting converted. Other building being built. More buildings could getting leased or bought.
– main critical path bottleneck is the power upgrades that are needed inside and outside

The City of Katy is not involved in this project in any way. The County of Waller and the City of Brookshire are the only local governing bodies involved in this undertaking. The EPA and the State of Texas will also be heavily involved.

Retrofit: there are 206 overhead doors that have to be removed and the openings closed off. Tesla has access to premier construction teams, but this is still a major undertaking.

Starting time: The warehouse currently has approximately 10,000 completed batteries that need to be removed prior to any retrofit beginning. There are also nearly 44 million battery cells on pallets that need to be relocated. Give or take 40,000 square feet of auto parts are in the building 111 Empire. The staff for loading and unloading trucks has been reduced to the bare minimum. My personal guesstimate is that mid to late June before the building is empty. The facility is still receiving freight, which works against clearing the building of all products. The facility recently received several loads of freight into the building.

The building will not be empty until June (unless there is a massive speedup in clearing operations). This is based on how many people are available to load trucks for the outbound products. This is also allowing for receiving additional products. This shifts your timeline by several months. This would make pre-production later Dec 2025-Feb 2026.

The main project timeline for converting the warehouse at 111 Empire Boulevard in Brookshire, Texas, into Tesla’s third Megapack factory looks like about 6 months. There could be 3 months of delay for the roofwork and clearing the building.

Current status – Warehouse must be cleared, roof has to be changed. Equipment is not installed, power has not been upgraded, reinforcement to allow 80 ton megapacks may not be needed.

Several key factors: the conversion of an existing structure, utility setup (especially power for heavy industrial use), regulatory approvals, Tesla’s experience with similar projects, and the specific context of Waller County and the City of Brookshire.

Info from someone who lives in the area and has been investigating. Tesla took a lease on the building in November 2022 and opened in December of the same year. The building was originally built as a logistics hub for heavy inbound/outbound freight. There are over 200 overhead doors. Four overhead doors with ramps to allow large trucks or equipment to be brought into the building. There is another building (117 Empire) on the west end of 111 Empire (1 million SF) that is to be leased. 117 Empire is 122,000 square feet on a 10 acre lot and it would form a line of three buildings- 117 empire, 111 empire and the new building. A new building is to be built which will be 616,000 square feet. Total square footage of three buildings will be about 1.77 million square feet. The Giga Texas car factory is 10 million square feet. There are several other large buildings in the area which could be leased or acquired.

Currently the building houses just under 10,000 batteries, auto parts, and many items related to the assembly line at Giga Texas.

Key Factors and Main Issues

Conversion of an Existing Warehouse
The building at 111 Empire Boulevard is a pre-existing 1.03 million square-foot warehouse, previously leased by Tesla since October 2021 and used by a third-party logistics company (DB Schenker) for auto parts handling. Converting it into a Megapack factory involves reconfiguring the interior for manufacturing rather than starting from scratch. This reduces the timeline compared to a ground-up build like the Shanghai Megafactory, which took seven months to construct (May 23, 2024, groundbreaking to December 2024 completion).

Tesla is investing approximately $194 million in upgrades and equipment, including $44 million for facility improvements and $150 million for manufacturing equipment. These upgrades likely include installing production lines, reinforcing the structure for heavy machinery (Megapacks weigh around 80 tons when fully assembled), and adapting the space for industrial use. Since the building is already complete, structural work should be minimal, focusing instead on interior retrofitting, which experienced construction teams can execute efficiently.

Utility Setup (Power Infrastructure)
Power is a critical bottleneck. A Megapack factory requires significant electrical capacity to operate heavy equipment, test batteries, and potentially charge units during production. The Shanghai Megafactory transitioned from building completion to production in about two months (December 2024 to trial production by late January 2025), suggesting utilities were pre-coordinated. In Texas, however, utility upgrades can take longer due to regulatory processes and coordination with local providers like CenterPoint Energy, which serves Waller County.

Tesla’s Gigafactory Texas (Giga Texas) in Austin faced utility challenges, requiring a new substation and transmission lines, but it benefited from proximity to a major grid hub. Brookshire, near Houston, is in a well-developed industrial area (Empire West Industrial Park), but the warehouse’s prior logistics use suggests its current power capacity is insufficient for manufacturing 40–160 GWh/year of Megapacks (estimates vary based on factory size comparisons).

Info from onsite investigator is $1 million of power grid work.

Upgrading transformers, substations, or grid connections could take 6–12 months if not pre-planned, though Tesla’s experience with Giga Texas and SpaceX’s Starbase may expedite this.

Regulatory Approvals and Permits
Waller County Commissioners Court approved a tax abatement agreement on March 5, 2025, and the City of Brookshire was set to consider additional incentives on March 13, 2025. These financial incentives indicate strong local support, likely streamlining other approvals. Tesla’s history in Texas (e.g., Giga Texas) shows it can navigate permitting efficiently, often securing preliminary approvals while construction progresses.

Remaining permits likely include building permits for interior modifications, electrical permits for utility upgrades, and environmental permits (e.g., air quality or waste handling for battery production). Texas is business-friendly, and Waller County’s economic development partnership has a track record of fast-tracking projects (e.g., spec buildings since 2010). Unlike Giga Berlin, which faced delays from environmental objections, Texas projects typically avoid such hurdles, especially for retrofits rather than new builds.

Tesla’s Experience and Supply Chain Readiness
This is Tesla’s third Megapack factory, following Lathrop, California (ramped to 40 GWh/year), and Shanghai (targeting 40 GWh/year by Q1 2025. I, Brian Wang, believe that Shanghai megapack will reach 80 GWH/year or more but others like Dillon Loomis must wait for clear capacity statements and proof that the space will be used to increase production). Tesla’s project teams are seasoned, and their Texas presence (Giga Texas, SpaceX facilities) means established relationships with local contractors and suppliers. The supply chain for Megapack components (cells, inverters, etc.) is likely optimized, with parts possibly sourced from Giga Texas or other U.S. facilities, reducing delays.

The Shanghai timeline (two months from completion to production) reflects Tesla’s ability to install equipment rapidly when utilities and permits align. Texas construction firms can likely match this efficiency.

Estimated Timeline
Based on the above, here’s a likely timeline starting from March 8, 2025 (today’s date):

Phase 0: Clearing the warehouse, fixing the roof (1-4 months)

Phase 1: Planning and Initial Permitting (0–1 month, March 8–April 8, 2025)
Tesla likely began planning before the March 5 announcement, given its lease since 2021. Remaining permits (building, electrical) can be secured in 2–4 weeks with Waller County and Brookshire’s support. Assume completion by early April.

Phase 2: Interior Retrofitting and Equipment Delivery (2–4 months, April 8–July 8, 2025)
Retrofitting the warehouse (installing production lines, reinforcing floors, etc.) could take 2–3 months, overlapping with equipment delivery. Tesla’s $194 million investment suggests pre-ordered machinery, which can be installed in 1–2 months once on-site, mirroring Shanghai’s pace.

Phase 3: Utility Upgrades (3–6 months, April 8–September 8, 2025)
Power infrastructure is the wildcard. If Tesla pre-coordinated with CenterPoint Energy, upgrades (e.g., substation enhancements) could finish in 3–4 months. Without prior planning, it might extend to 6 months. Assume 4–5 months as a midpoint, running parallel to retrofitting.

Phase 4: Equipment Installation and Testing (1–2 months, July 8–September 8, 2025)
Once power is ready, installing and testing equipment takes 1–2 months, consistent with Shanghai. Trial production could start by late August if utilities align early, or September if delayed.

Total Timeline: 5–6 Months (March 8–August/September 2025) – Possible 3 months Phase 0 – to fix the roof and clear the warehouse.
Trial production could begin by August 2025 if utilities are expedited (5 months total), or September 2025 (6 months) if power upgrades lag. Mass production would follow a 3–6 month ramp-up, targeting Q1 2026 (January–March).

Remaining Regulatory and Permit Steps

Building Permits: Likely minor, as it’s a retrofit. Waller County can issue these within weeks, especially with tax incentives in place.

Electrical Permits: Required for utility upgrades. Coordination with CenterPoint Energy and the Texas Public Utility Commission (PUC) may take 1–2 months but can overlap with construction.

Environmental Permits: Battery production involves chemicals, so air quality or waste permits may be needed. Texas’s laxer regulations (compared to California or the EU) suggest quick approval (1–2 months), likely already in progress given Tesla’s experience.

Occupancy and Safety Certifications: Final inspections post-retrofit, typically 2–4 weeks once equipment is installed.

Main Issues and Mitigations

Fixing the roof (206 doors) and clearing the warehouse.
Power Delay Risk: The biggest hurdle. Tesla could mitigate this by leasing temporary generators (as done at Giga Texas) or pushing CenterPoint for priority service, leveraging its economic impact (1,500 jobs).
Supply Chain Hiccups: Unlikely, given Tesla’s U.S. network, but global shipping delays could push equipment installation back by 1–2 months.
Regulatory Surprises: Low risk in Texas, but any unforeseen environmental pushback could add 1–2 months. Waller County’s proactive stance minimizes this.

Estimating 8-10 Months to First Megapack
The conversion of 111 Empire Boulevard into a Megapack factory would take 5–6 months from March 8, 2025, with trial production starting between August and September 2025. However, there is roof work and clearing the warehouse which could delay work by 3 months. So 8-10 months. The main issues are clearing the warehouse, fixing the roof, utility power readiness, which could stretch the timeline if not pre-planned, but Tesla’s experience and Texas’s business-friendly environment should keep delays minimal. Most regulatory hurdles are cleared, with only routine permits remaining, likely processed concurrently with construction.
